Dynamic Programming Algorithm: Automotive Assembly Line Scheduling Problem

tags: Dynamic planning  algorithm

1 Problem Description

There are two assembly lines in a car factory.,Each one has n Assembly stations. Assembly line i First jAssembly stations are indicated as Si,j ,The assembly time at the station is ai,j . A car chassis enters the factory,Then enter the assembly line i(i for 1 or 2),Spend time ei . In the first line j After assembly station,This chassis came to the first of any assembly line(j+1)Assembly stations. If it stays on the same assembly line,There is no movement overhead. but,If it moves to another line,Take time for ti,j . On the first line leaving an assembly line n After assembly station,The completed car chassis takes time xi Leave the factory. The problem to be solved is,Determined should be in the assembly line 1 Which stations are selected?,In the assembly line 2 Which stations are selected?,In order to make the total time of the car through the factory the shortest.

2 Algorithm analysis

The following is a step-by-step analysis of the assembly line scheduling problem through dynamic programming ideas.

2.1 step 1:Describe the characteristics of the optimal solution structure

Observe one through the assembly station S1,j Fastest route,Found that it must be through the assembly line 1 or2 Assembly station(j-1). therefore,By assembly station S1,j The fastest route can only be one of the following:

By assembly station S1,j−1 Fastest route,Then directly through the assembly station S1,j

By assembly station S2,j−1 Fastest route,From the assembly line 2 Transfer to assembly line 1,Then through the assembly station S1,j

So looking for an assembly station through any assembly line j Fastest route,We can plan to find the assembly station through the two assembly lines first. j-1 The fastest route.

2.2 step 2: Defining the value of an optimal solution using the most recursive problem of the problem

Remember fi [j] Represents a car chassis from the starting point to the assembly station Si,j The fastest possible time;f  Indicates the fastest time for the chassis to pass through all assembly stations in the factory.

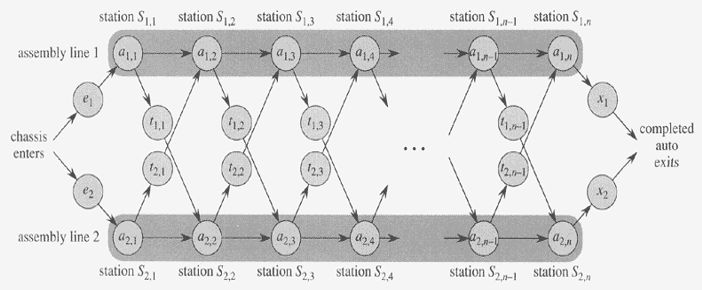

https://images0.cnblogs.com/blog/382408/201410/061536211406212.png

2.3 step 3:Calculate the fastest time

The execution time of the recursive algorithm is about n Index form,So we use the low-up implementation method to calculate the fastest time. Remember li [j] Indicates entering the assembly station Si,j Which assembly line from the previous assembly station;l Indicates which assembly line leaves the factory.

FATEST-WAY(a, t, e, x, n)

    f1 [1] ← e1 + a1,1

    f2 [1] ← e2 + a2,1

    for j ← 2 to n

        if f1 [j 1] + a1,j ≤ f2 [j 1] + t2,j1 + a1,j

        then f1 [j] ← f1 [j 1] + a1,j

                l1 [j] ← 1

        else f1 [j] ← f2 [j 1] + t2,j1 + a1,j

                l1 [j] ← 2

        endif

        if f2 [j 1] + a2,j ≤ f1 [j 1] + t1,j1 + a2,j

        then f2 [j] ← f2 [j 1] + a2,j

                l2 [j] ← 2

        else f2 [j] ← f1 [j 1] + t1,j1 + a2,j

                l2 [j] ← 1

        endif

    endfor

    if f1 [n] + x1 ≤ f2 [n] + x2

    then f ← f1 [n] + x1

            l ← 1

    else f ← f2 [n] + x2

            l ← 2

    endif

end

2.4 step 4:Construct the fastest route through the factory

According to the steps 3 acquired li [j] with l To print out the route that takes the smallest assembly line schedule.

PRINT-STATIONS(l, l , n)

    i ← l

    print ’line:’ i ’, station:’ n

    for j ← n downto 2

         i ← li [j]

         print ’line:’ i ’, station:’ j-1

    endfor

end

3   C Language implementation verification

Now suppose that there are two 5 Assembly line assembly line,The scheduling time of each assembly line is as shown in the figure below.,

https://images0.cnblogs.com/blog/382408/201410/061541229689922.png

Figure 1: Assembly line example diagram

among them,The left side of the assembly line is the entrance,On the right is the exit,The numbers on the entrance and exit indicate the time spent entering the assembly line and leaving the assembly line, respectively. Green circle indicates assembly station,The number in the circle indicates the assembly time at the assembly station. The numbers on the lines between the various assembly lines indicate the time it takes to transfer from one assembly line to another.

use C The language verification code is as follows,

https://images.cnblogs.com/OutliningIndicators/ContractedBlock.gif View Code

Compile the program,Generate and execute files AssemblyLineSchedule,

lienhua34:algorithm$ gcc -o AssemblyLineSchedule AssemblyLineSchedule.c

lienhua34:algorithm$ ./AssemblyLineSchedule

The cost of the fastest path: 19

line: 2, station: 5

line: 2, station: 4

line: 2, station: 3

line: 1, station: 2

line: 1, station: 1

then,The shortest path takes a total of time 19,Its path is as follows in the red line,

https://images0.cnblogs.com/blog/382408/201410/061543233905412.png

Figure 2: Example line of an assembly line with the fastest path
